MANAGEMENT PLAN

management

+ Font mai mare | - Font mai mic

MANAGEMENT PLAN

Name:

CMA Project

Title:

Contract Management & Administration Process Improvement Project

Date:

Release #:

Project Manager:

Approvals:

Name

Project Role

Signature

Date

Project Sponsor

Steering Committee Chairman/ Resource Manager

Steering Committee / Resource Manager

Steering Committee / Resource Manager

Steering Committee / Resource Manager

Steering Committee / Resource Manager

Steering Committee / Resource Manager

Steering Committee / Resource Manager

Steering Committee / Resource Manager

Project Manager/ Steering Committee

Project Manager Consultant

The above signatures represent agreement with the attached plan including agreement with the activities, the risks, the effort and the cost of the associated project

Revision History

Introduction

Purpose of Project Plan

Project Plan Content

Project Scope Statement

Purpose of Project Scope Statement

Work Breakdown Structure - (WBS)

Purpose of WBS

WBS Information

Project Schedule

Major Milestones

Project Schedule

Project Organization Plan

Purpose of Project Organization Plan

Abbreviations

Project Stakeholders

Stakeholder Directory

CMA Project Organization Chart

Project Communication Plan

Purpose of Project Communication Plan

Communications Plan

Scope Management Plan

Purpose of Scope Management Plan

Scope Management

Change Control Process

Change Analysis Framework

Risk Management Plan

Purpose of Risk Management

Risk Management Process

Risk Identification

Risk Identification Summary (Top Five Risk)

Annexes

Tools and techniques for developing WBS. Decomposition

Role Description

Project Sponsor Role

Steering Committee Role

Project Manager Role

Development Team Role

End User

Change Request Form (Cerere de Modificare)

Risk Management Worksheet

Suggested Preventive and Contingency Measures

List of Figures

Figure 1. CMA Project Organization Chart

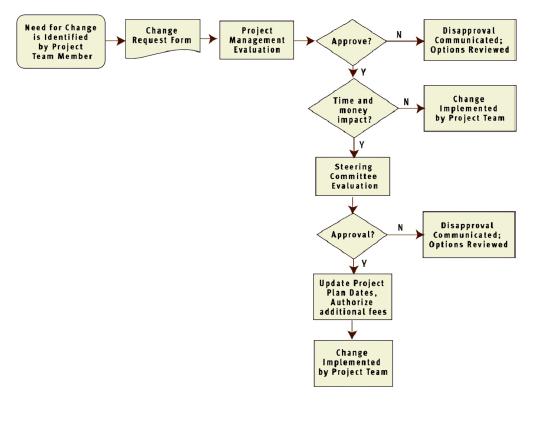

Figure 2. Change Management Process

1

Introduction

Introduction

Purpose of Project Plan

The project plan is a formal, approved document used to manage project execution.

The project plan is used to:

  • Guide project execution.
  • Document project planning assumptions.
  • Document project planning decisions regarding alternatives chosen.
  • Facilitate communication among stakeholders.
  • Define key management reviews as to content, extent, and timing.
  • Provide a baseline for progress measurement and project control.

Project Plan Content

The project plan is a document or collection of documents that should be expected to change over time as more information becomes available about the project.

The project plan commonly includes all of the following (these items are described in more detail elsewhere):

  1. Project charter.
  1. Scope statement, which includes the project objectives and the project deliverables.
  1. WBS to the level at which control will be exercised, as a baseline scope document.
  1. Schedule baseline (project schedule) and the cost baseline (timephased project budget).
  1. Cost estimates, scheduled start and finish dates (schedule), and responsibility assignments for each deliverable within the WBS to the level at which control will be exercised.
  1. Major milestones and target dates for each.
  1. Project organization plan. Key or required staff and their expected cost and/or effort.
  1. Risk management plan, including: key risks, including constraints and assumptions, and planned responses and contingencies (where appropriate) for each.
  1. A description of the project management approach or strategy
  1. Open issues and pending decisions.
  1. Subsidiary management plans, namely:
    1. Scope management plan
    2. Schedule management plan
    3. Cost management plan
    4. Quality management plan
    5. Communications management plan
    6. Risk response plan
    7. Procurement management plan

2

Project Scope Statement

Project Scope Statement

Purpose of Project Scope Statement

The scope statement provides a documented basis for making future project decisions and for confirming or developing common understanding of project scope among stakeholders. As the project progresses , the scope statement may need to be revised or refined to reflect approved changes to the scope of project.

A. Business Need:

(the project justification, describe why the project was undertaken; more detail than in Project Charter)

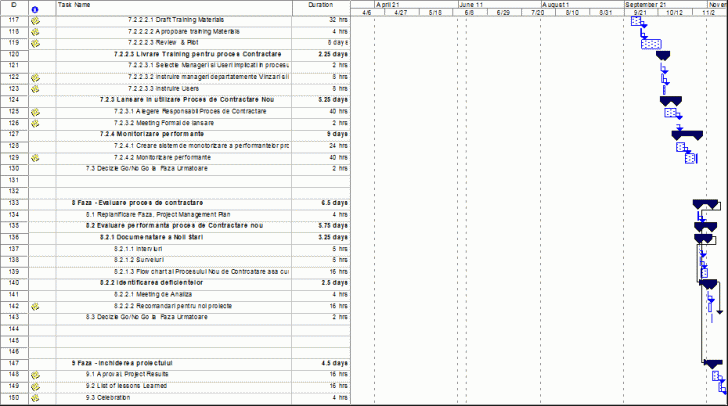

Managementul contractelor nu satisface nevoile actuale de business - au fost situatii in care contractele semnate nu protejau interesele companiei, nefiind specificate:

- obligatiile clientului in cadrul proiectului,

- criteriile de acceptanta, calitative si cantitative,

- procedura de schimbare sau completare a cerintelor, permitand adaugarea de cerinte noi sau schimbarea cerintelor de catre client intr-un mod necontrolat,

- termenele si conditiile de plata,

- nu erau separate contractul cadru de contractele specifice (realizare soft, consultanta si analiza, implementare/integrare solutii etc) producand confuzii in privinta proiectului

Datorita lipsei unei proceduri aplicate de realizare a contractului, adesea faza de analiza a cerintelor si elaborarea specificatiilor este parcursa superficial cu consecinte negative asupra profitabilitatii proiectului, constatandu-se dupa semnarea contractului si demararea proiectului ca efortul necesar este mult mai mare decat cel estimat initial si cuprins in contract (piata romaneasca)

Lipsa unei proceduri clare de contractare conduce la situatii de indisciplina, in care un contract este trimis clientului inainte de a fi vizat de catre cei implicati, cum ar fi: responsabil tehnic, jurist, financiar, comercial.

B. Project's product:

(brief summary of product description, but more than in Project Charter)

Proiectul reprezinta o faza aplicata pe piata romaneasca, cu beneficiari: Vanzari Romania si BIS

1. Analiza situatiei actuale in privinta procesului si procedurilor de contractare

2. Designul procesului si procedurilor de contractare, configuration management

3. Analiza templateurilor de contrat folosite pana in prezent

4. Redactarea template-urilor de contract corespunzatoare unor situatii clar specifice

5. Realizarea si implementarea unui program de instruire cu privire la principiile de realizare a contractelor, procedura de contractare din Softwin, tehnici de negociere in contractare. Participatii sint : Departament Vanzari Romania, Account Manageri BIS, CRM, ePublishing, Director vanzari Softwin, Directori Divizii, Directori Comerciali Divizii

6. Desemnarea (selectia) unui owner al procesului de contractare din Softwin, a responsabilitiatii si autoritatii lui

7. Mecanism pentru a masura eficienta noului proces de contractare

C. Project deliverables

(list of summary-level subproducts whose full and satisfactory deliverables marks completion of the project)

1. Raport analiza situatie actuala contractare:

- descriere proces actual

- procedurile existente

- responsabili, autoritate si responsabilitati

2. Designul unui proces nou de contractare si proceduri de contractare si configuration management conform SACS

3. Raport de analiza a template-urilor existente

4. Template-uri pentru contracte in limba romana:

a. contract cadru integrare solutii

b. contract dezvoltare software

c. contract mentenata software

d. contract configurare

e. contract integrare software/hardware

f. subcontractare (outsourcing)

g. contract furnizare servicii

h. contract furnizare produse software (licente)

5. Instruire

5.1. Program instruire:

- principii in contractare

- procedura de contractare in SOFTWIN

- tehnici de negociere in contractare

5.2. Formare traineri

6. Desemnarea owner proces contractare

- job description

- task list

- sistem evaluare performanta

- recrutare si selectie

7. Mecanism masurare eficienta proces contractare

- modul de lucru (colaborare)

- viteza de lucru

- performanta contractelor (satisfactia celor implicati si afectati - comercial, tehnic, project management)

8. Project Charter

9. Project Plan

D. Project Quantifiable Objectives:

(quantifiable criteria that must be met for the project to be considered successful. Must include at least cost, schedule and quality measures. )

1. cost

- timp

- financiar

2. design si implementare proceduri contractare

3. livrare training contractare

4. templaturi

- redactare

- instruire

- comparatie cu contractele anterioare

E. Success Factors:

List factors that will be used to determine the success of the project. This part of the project statement should answer the question, "How do we know if the project was successful?" It is essential that the criteria be quantifiable and measurable. Short-term success factors are used to determine if a project is complete.

Short Term

existenta unui proces si a procedurilor care sa reglementeze contractarea

aceste proceduri sunt publicate in SACS, s-a facut instruire si sunt respectate

templaturile sunt folosite

cei implicati se declara satisfacuti cu privire la proceduri si template-uri (survey la care participa: echipa Vanzari Romania, Managementul BIS, CRM, ePUB, DSD)

Long Term

problemele datorate erorilor de contractare se reduc cu minim 80% (survey dupa minim 6 luni de la incheierea proiectului, in care se vor evalua nr si dimensiunea erorilor comparativ cu perioada de dinainte de contract). Evaluarea va fi realizata de catre Vanzari Romania si BIS.

F. Assumptions:

Proiectul beneficiaza de o atentie deosebita (prioritate mare) din partea celor implicati si a managementului companiei

Proiectul reprezinta o faza pilot aplicat la Vanzari Romania si BIS. In urma evaluarii rezultatelor pilotului se poate decide extinderea si la alte departamente sau la nivelul companiei.

G. constraints:

Resurse: timp, financiare si umane.

H. RISKS:

Rezistenta la schimbare a personalului

Neimplicarea managementului: lipsa suport, alocare personal

Lipsa personal disponibil

Lipsa buget dedicat

3

WORK BREAKDOWN STRUCTURE

(WBS

Work Breakdown Structure - (WBS)

Purpose of WBS

WBS is a deliverable-oriented grouping of project components that organizes and defines the total scope of project

Together wit the project scope statement, the WBS is used to develop or confirm a common understanding of project scope.

Work not in the WBS is outside the scope of the project and will not be performed.

WBS Information

Phase

Activity Number

Activity Name/ Deliverable

Est.
Dur.

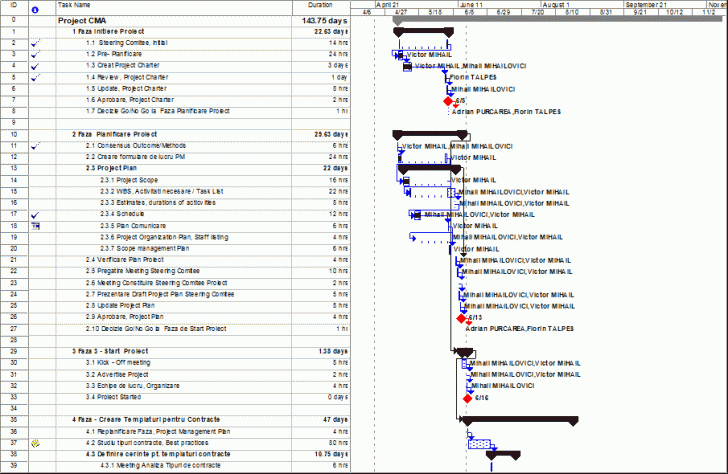

Initiere Proiect

Faza Initiere Proiect

' Steering Comitee, Initial'

14h

Pre- Planificare

24h

Creat Project Charter

3d

'Review, Project Charter'

1d

'Update, Project Charter'

8h

'Aprobare, Project Charter'

2h

Decizie Go/No Go la  Faza Planificare Proiect

1h

Planificare Proiect

Faza Planificare Proiect

Consens Rezultate/Metode

6h

Creare formulare de lucru PM

33h

Project Plan

Project Scope

16h

'WBS, Activitati necesare / Task List'

54h

'Estimari, duratele acticvitatilor'

5h

Schedule

12h

Plan Comunicare

8h

Project Organization Plan

11h

Scope management Plan

6h

Verificare Plan Proiect

4h

Pregatire Meeting Steering Comitee

10h

Meeting Constituire Steering Comitee Proiect

2h

Prezentare Draft Project Plan Steering Comitee

5h

Update Project Plan

5h

'Aprobare, Project Plan'

4h

Decizie Go/No Go la  Faza de Start Proiect

1h

Start Proiect

Faza - Start Proiect

Kick - Off meeting

5h

Publicitate Project

2h

'Echipe de lucru, Organizare'

4h

Proiect Demarat

0d

Creare Templaturi pentru Contracte

Faza - Creare Templaturi pentru Contracte

'Replanificare Faza, Project Management Plan'

4h

'Studiu tipuri contracte, Best practices'

80h

Definire cerinte pt. templaturi contracte

Meeting Analiza Tipuri de contracte

6h

Tipuri de contracte necesare in Softwin (Document)

16h

Forma contractelor

8d

Creare Templaturi

Template Contract Dezvoltare Soft

40h

Template Contact Integrare Solutii

40h

Template Contact Mentenanta

20h

Alte tipuri de Contracte definite in etapa de Studiu

40h

Creare Ghid de lucru

40h

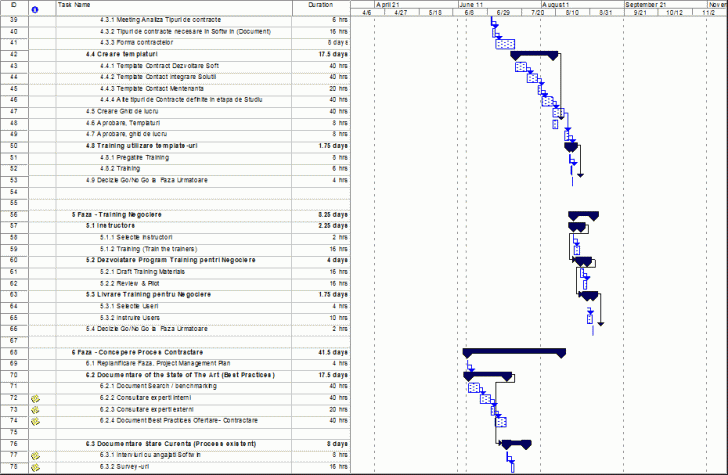

'Aprobare, Templaturi'

8h

'Aprobare, Ghid de lucru'

8h

Training utilizare template-uri

Pregatire Training

8h

Training

6h

Decizie Go/No Go la  Faza Urmatoare

4h

Training Negociere

Faza - Training Negociere

Instructors

Selectie Instructori

2h

Training (Train the trainers)

16h

Dezvolatare Program Training pentri Negociere

Draft Training Materials

16h

Review & Pilot

16h

Livrare Training pentru Negociere

Selectie Useri

4h

Instruire Users

10h

Decizie Go/No Go la  Faza Urmatoare

2h

Concepere Proces Contractare

Faza - Concepere Proces Contractare

'Replanificare Faza, Project Management Plan'

4h

Documentare of the State of The Art (Best Practices)

Document Search / benchmarking

40h

Consultare experti interni

40h

Consultare experti externi

20h

Document Best Practices Ofertare- Contractare

40h

Documentare Stare Curenta (Process existent)

8d

Interviuri cu angajati Softwin

8h

Survey-uri

16h

Flowchart al procesului curent

20h

'Review,  Document proces curent'

16h

'Update, Document proces curent'

4h

'Aprobare Steeering Comitee, Document Stare Curenta'

2h

Identificarea procesului imbunatatit de contractare

15.25d

Identificare Stare Dorita (Process Nou/Imbunanatit)

40h

Gap Analisys / Analiza procesului curent fata de cel dorit

20h

Solutiile cele mai probabile / Alternative

5d

Brainstorming

8h

Flowcharturi ale Variantelor Procesului Dorit

16h

Benefit/Cost Analisys al fiecarui process nou propus

16h

Prezentare Alternative Proces Nou de Contractare

12h

Selectare Recomanadare Proces Nou Contractare

8h

'Aprobare Steering Comitee, Process Nou Contractare'

2h

Decizie Go/No Go la  Faza Urmatoare

2h

Implementare Process Contractare

Faza - Implementare Process Contractare

60.25d

Replanificare Faza, Project Management Plan'

4h

Proces Contractare

59.5d

Documentare Proces de Contractare

25.5d

Draft Flowchart Proces Contractare

8h

Draft Process

14d

Draft Proceduri de lucru (SACS) (Work Instructions)

64h

Draft Formulare de lucru pentru proces

48h

Documentartie Process

5.5d

Asamblare Documentatie

20h

Review Document Steering Comitee

24h

Aprobare Documentatie Process, Sterring Comitee

2h

Publicare

5d

Printare si Distribuire

8h

Intranet

16h

SACS

16h

Training

19.7d

Instructori

5d

Selectie Instructori

24h

Training (Train the trainers)

16h

Dezvolatare Program Training pentru proces

12.5d

Draft Materiale Training

32h

Apropbare materiale training

4h

Review & Pilot

8d

Livrare Training pentru proces Contractare

2.25d

Selectie Manageri si Useri implicati in procesul

2h

Instruire manageri departatemente Vinzari si BIS

8h

Instruire Utilizatori

8h

Lansare in utilizare Proces de Contractare Nou

5.25d

Alegere Responsabil Proces de Contractare

40h

Meeting Formal de lansare al noului proces

2h

Monitorizare performante

9d

Creare sistem de monitorizare a performantelor proces

24h

Monitorizare performante

40h

Decizie Go/No Go la Faza Urmatoare

2h

Evaluare proces de contractare

Faza - Evaluare proces de contractare

6.5d

'Replanificare Faza, Project Management Plan'

4h

Evaluare performanta proces de Contractare nou

5.75d

Documentare a Noii Stari

3.25d

Interviuri

5h

Surveiuri

5h

Flowchart al Procesului nou asa cum este utilizat in practica

16h

Identificarea deficientelor

2.5d

Meeting de Analiza

4h

Recomandari pentru noi proiecte

16h

Decizie Go/No Go la  Faza Urmatoare

2h

Inchiderea proiectului

Faza - Inchiderea proiectului

4.5d

Aproval, Project Results

16h

List of lessons Learned

16h

Celebration

4h

4

Project Schedule

Project Schedule

Major Milestones

Summarize the Project Schedule by listing the Milestones or Events on the critical path of the Project Schedule. The critical path is: a series of activities, which determine the earliest completion time of the project. For each event, provide the Projected Date of completion and a brief description of the Significance of the Milestone or Event listed.

Milestone or Event

Projected Date of Completion

Significance

Creat Project Charter

TBD

Project Plan Construit

TBD

Meeting Constituire Steering Comitee Proiect

TBD

Aprobare, Project Plan

TBD

Activitatea pe Proiect Demarata

TBD

Document Sinteza Best Practices, Creat

TBD

Template Contract Dezvoltare Soft

TBD

Template Contact Integrare Solutii

TBD

Template Contact Mentenanta

TBD

Creare Ghid de lucru

TBD

Training Strategii de Negociere

TBD

Document Best Practices Ofertare- Contractare

TBD

Documentare Stare Curenta (Process existent)

TBD

Aprobare Steeering Comitee, Document Stare Curenta

TBD

Prezentare Alternative Proces Nou de Contractare

TBD

Process Nou Contractare, Aprobat Steering Comitee

TBD

Documentatiea Procesului nou de contractare, Publicata

TBD

Training process nou de contractare efectuat

TBD

Responsabil Process de contractare numit

TBD

Process nou de contractare lansat oficial

TBD

Proces de contractare nou evaluat

TBD

Proiect CMA incheiat

TBD

Project Schedule

An electronic version can be found at:

https://projsrv.softwin.ro/projectserver

https://projsrv/projectserver

5

Project Organization Plan

Project Organization Plan

Purpose of Project Organization Plan

The Project Organization Plan identifies, documents, and assigns project roles, responsibilities, and reporting relationships. Roles, responsibilities, and reporting relationships may be assigned to individuals or to groups. The individuals and groups may be part of the organization performing the project, or they may be external to it.

The results of project organization planning should be reviewed regularly throughout the project to ensure continued applicability. If the initial organization is no longer effective, then it will be revised promptly.

Abbreviations

PM - Project Manager

SC - Steering Comitee

PS - Project Sponsor

DT - Development Team

Project Stakeholders

Stakeholders are those with a vested interest in the success of the project. The identification and input of stakeholders helps to define, clarify, change, and contribute to the scope and, ultimately, the success of the project.

To ensure project success, stakeholders are identified early in the project, their needs and expectations are determined, and we strive to manage those expectations over the course of the project.

Stakeholders on this project include:

  • Project Manager, who has ultimate responsibility for ensuring project success.
  • Project Sponsor, who leads in getting the need for the project recognized.
  • Users, who are the persons using the product of the project.
  • Management, who refines business needs of the project.
  • Development Team members, who are responsible for performing the work on the project.
  • Configuration management and quality control entities.
  • Legal Department, who provide legislative oversight.
  • Resource managers, who allocate the resources (people, equipment, etc) as necessarry

The management of stakeholder expectations is potentially difficult because of conflicting goals and expectations.

The expectations may require more resources than are currently available.

Stakeholder Directory

Name/Title

Department

Project Role

Phone

Email

Florin Talpes / Director General

DG

Project Sponsor

Adrian Purcarea /Director General Adjunct

DG

SC Chairman/ Resource Manager

Stefan Diaconescu / Director BIS

BIS

SC / Resource Manager

Claudiu Bulaceanu / Director dept. SAP

BIS

SC / Resource Manager

Metodiu Mehmet / Director Vinzari Ro

Vinzari Ro

SC / Resource Manager

Elisabeta Nichifor / Director dept. CRM

CRM

SC / Resource Manager

Mariuca Talpes / Director divizie ePublishing

ePublishing

SC / Resource Manager

Carmen Buzatu / Director Financiar

Finaciar

SC / Resource Manager

Ion Radoslovescu / Director Calitate

QA

SC / Resource Manager

Mihail Mihailovici / Director Vinzari

DG

Project Manager/ SC

Victor Mihail / Project Manager

BIS

Project Manager Consultant

Romanita Mateescu / Consilier Juridic

Legal

Development Team Member

Tudor Zavulan / Responsabil Calitate

QA

Development Team Member

Marcel Isaila / Business Solution Architect

Vinzari Ro

Development Team Member

Octavian Cristea / Director Comercial

CRM

Development Team Member

Gabriela Nita

HR

Development Team Member

Camelia Nicolau

HR

Development Team Member

CMA Project Organization Chart

Figure . CMA Project Organization Chart

6

Project Communication Plan

Project Communication Plan

Purpose of Project Communication Plan

This document addresses the Comunications Planning for the project.

Communications planning involves determining the information and communications

needs of the stakeholders:

  • who needs what information,
  • when they will need it,
  • how it will be given to them, and
  • by whom.

The results of project communications planning should be reviewed regularly throughout the project and revised as needed to ensure continued applicability. If the initial communications plan is no longer effective, then it will be revised promptly.

.

Communications Plan

A.    Communications technology

The technologies or methods used to transfer information back and forth among project stakeholders.

1. Meeting-uri

2. e-mail - Outlook

3. Intranet - Microsoft Project Server and Web Access ( https://projsrv.softwin.ro/projectserver sau https://projsrv/projectserver )

4. Avizier dedicat Proiectului (TBD)

B.     Information Description, Collection, and Reporting

For each Information Need, describe the information, the provider of the information, when and how is it collected, and how the information will be reported.

Information

Need

Description of Information

Provider of Information

How is Information Collected

How is Information Reported

Detailed Status of Assigned Tasks

1. Work Performed Last Period

2. Work planned for next period

3. Hot Issues

Team Member

Project WEB site

sau e-mail

Detailed Status Report

Project Status

1. Major Accomplishments

2. Objectives for the Next Period

3. Hot Issues

4. Risks

Project Manager

Meeting

Project Status Report

Summary of project status

1. Cost & Schedule Variations

2. Major Acomplishments

3. Future Milestones

4. TBD

Project Manager

Afisare la Avizier

Project Dashboard

D.    Distribution Methods

List each report or document needed to communicate the information (in the first column) identified in the last column of Section C. Identify the primary and secondary distribution methods for each report or document (e.g., voice, electronic mail, spreadsheet, formal presentation). Specify the frequency or distribution for each report or document.

Report or Document

Primary Distribution Method

Secondary Distribution Method

Distribution Frequency

Detailed Status Report

Web Site

E-mail

Saptaminal

Project Status Report

Meeting Steering Comitee

E-mail

La 2 saptamini

Project Dashboard

Avizier

Web site, E-mail

La 2 saptamini

E.     Distribution Groups

Organize into logical groups, stakeholders identified in section B, who have common information needs. List the stakeholder(s) for each group in the columns provided. Specify the common information needs for each group.

Group Name

Project Sponsor

Steering Committee

Project Management

Users

Common Information Needs:

Project Dashboard

Project Status Report

Project Status Report

Detailed Status Report

Deliverables

F.     Method for Updating the Communications Plan

Describe who, when, and how the Communications Plan will be maintained.

Managerul de Proiect va updata acest plan in cadrul activitatii de review al planului de la inceputul fiecarei faze de proiect

7

Scope Management Plan (Change Control)

Scope Management Plan

Purpose of Scope Management Plan

The purpose of Scope management Plan (Change Control) is to provide the standards and procedures for submitting, analyzing and approving or disapproving changes that occur after the official requirements have been agreed upon (i.e., 'signed off').

A scope change is any modification to the agreed-upon project scope as defined by the approved WBS. Scope changes often require adjustments to cost, time, quality, or other project objectives.

Project scope changes are fed back through the planning process, technical and planning documents are updated as needed, and stakeholders are notified as appropriate.

Scope Management

This process provides a framework for minimizing changes that impact the scope, schedule, and cost of the project, while facilitating project team members' ability to make simple improvements to the solution.

Changes in the project approach, business requirements, technology, and resources will impact key components of the implementation plan. Such changes must be managed and controlled by the project management team, in order to prevent increased customer cost, delayed delivery schedule, and decreased quality of the overall solution.

Figure . Change Management Process

eFORCE Project Management Methodology

Change Control Process

The following describes the Change Control process (as outlined in the diagram above):

STEP 1: A project team member identifies the need for a change in an area where the requirements, approach, or plan has already been approved (i.e., 'signed off') by the project management team. He/she (i.e., 'Change Originator') completes a 'Change Request Form' (Annex) and forwards it to his/her project manager-either the Client Project Manager or Softwin Project Manager. The completed request describes the business, technical, or change management issue the request is trying to address, the desired outcome of the change, and detailed justification for the change.

STEP 2: The project manager analyzes the initial change request. If it is valid, he/she submits the request to the Project Manager, who logs the request in the Change Control Log. The Project Manager evaluates the priority of the request and arranges a meeting (via PM Review, Issue Management, or ad-hoc meeting) for the entire project management team to discuss and analyze.

STEP 3: The entire project management team analyzes the request and agrees to approve or disapprove. If the request is disapproved, the originating team member's project manager communicates the outcome, and reviews options/workarounds (as discussed in the project management review of the request). The Softwin Project Manager logs the request as is approved on the Change Control log. If the request is approved, the project management must thoroughly evaluate any impacts to the project scope, schedule, and cost. If there are any impacts to these stated areas, the request must be presented to the Steering Committee for approval. If there are no impacts to project scope, schedule, or cost, the change is communicated to the originating team by their respective project manager. The Software Project Manager logs the request as approved on the Change Control Log, and communicates it on the weekly status report.

STEP 4: If the request is approved, and there is an impact to scope, schedule, or cost, the Softwin Project Manager arranges for a Steering Committee review. The Steering Committee evaluates the request and makes a decision to approve or disapprove. If the decision is disapproval, the originating team's project manager communicates the outcome to his/her respective team members, and reviews options/workarounds (as discussed with the Steering Committee members). The Softwin Project Manager logs the request as disapproved on the Change Control Log. If the request is approved, the respective project manager communicates the change to their originating team. The Softwin Project Manager logs the request as approved on the Change Control Log and communicates on the weekly status report. The project plan is revised to reflect the change in scope and delivery dates, and the client authorizes the additional funding as necessary, often via a purchase order.

Change Analysis Framework

Listed below are the criteria that should be used to determine whether or not the change request should be approved or disapproved:

  1. Does the change include valid justification?
  2. Is the change essential at this point in the project, or can it be deferred to post-production efforts?
  3. Is the change outside the agreed-upon scope of this stage of the project?
  4. What tasks will be impacted by this change? Are there any critical path tasks?
  5. What is the work effort estimated to implement this change?
  6. What is the impact to the project schedule?
  7. Are additional resources required to implement this change?
  8. Are any other applications or projects impacted by this change?
  9. Are there any risks associated with implementing this change?
  10. Are there any costs associated with this change?

8

Risk Management Plan

Risk Management Plan

Purpose of Risk Management

Risk management is the systematic process of identifying, analyzing, and responding to project risk. It includes maximizing the probability and consequences of positive events and minimizing the probability and consequences of adverse events

Project risk includes both threats to the project's objectives and opportunities to improve on those objectives. It has its origins in the uncertainty that is present in all projects. Known risks are those that have been identified and analyzed, and it may be possible to plan for them.

The Risk Management Plan documents the procedures used to manage risk throughout the project. In addition to documenting the results of the risk identification and analysis phases, it must cover who is responsible for managing various areas of risk, how risks will be tracked throughout the life cycle, how contingency plans will be implemented, and how project resources will be allocated to handle risk.

Risk Management Process

Risk management deals with the following risk phases:

Risk identification

Risk analysis, quantification and prioritization

Risk mitigation planning

Risk response

Risk Identification

Project risks are identified and carefully managed throughout the life of the project.. Risk identification is a recurring event at occurs at all stages of the project

Risk identification consists of determining risks that are likely to affect the project and documenting the characteristics of those risks. Not all possible risks that might affect the project are idenytified, but only those likely to affect the project's success.

All members of the project team can identify risk, but the project manager has overall responsibility

A Risk Management Worksheet (shown later in this section) is used to manage risks. The worksheet is updated to reflect further risks identified. Also during the project, risks identified earlier may be removed.

Risks are documented so that contingency measures can be taken to mitigate their effects. Risks to both the internal and external aspects of the project should be tracked. Internal risks are those items the project team can directly control (e.g., staffing), and external risks are those events that happen outside the direct influence of the project team (e.g., legislative action).

Risk identification, management, and resolution continues throughout the life of the project. New risks are developed as the project matures and external and internal situations change. Old risks may go away or decrease in likelihood

Contingency plans are developed as a result of a risk being identified. Contingency plans are pre-defined action plans that can be implemented if identified risks actually occur. If a problem actually occurs, the contingency plan must be implemented and reserves must be allocated.

As a guideline, contingency plans are developed for the top five risks associated with a project. To properly implement a plan, a reserve is usually required where dollars and/or time are held by a project manager to apply to the execution of a contingency plan

Risk Identification Summary (Top Five Risk)

Category

Prob

Impact

Risk

Mitigation Approaches

Management

Personnel Availability

High

High

Personnel is not directly managed by the Project manger

Schedule

med

Med

The deliverable will not be ready on time

Legend: Prob = Probability of Occurence

9

Annexes

Annexes

Tools and techniques for developing WBS. Decomposition

Decomposition involves subdividing the major project deliverables or sub deliverables into smaller, more manageable components until the deliverables are defined in sufficient detail to support development of project activities. Decomposition involves the following major steps:

Identify the major deliverables of the project, including project management.

Decide if adequate cost and duration estimates can be developed at this level of detail for each deliverable. The meaning adequate may change over the course of project. Decomposition of a deliverable that will be produced far in the future may not be possible at this time.
For each deliverable, proceed to step 4 if there is adequate detail, or to step 3 if there is not. (Different deliverables may have differing levels of decomposition)

Identify constituent components of the deliverable. Repeat Step 2 on each constituent component

Verify correctness of the decomposition:

a.        Are the lower level items both necessary and sufficient for completion of the decomposed item? If not the constituents components must be modified (add, delete, redefine)

b.       Can each item be appropriately scheduled? Budgeted? Assigned to a specific organizational unit (department, team, person) who will accept responsibility for satisfactory completion of item? If not, revision are nodded to provide adequate management control

Role Description

Project Sponsor Role

One of the important project stakeholders is the project sponsor. The project sponsor should have the influence to ensure that the project has sufficient priority to enable success. The sponsor along with the Steering Committee is also responsible for providing the funding and staffing resources to complete the project successfully.

The project sponsor usually represents the recipient of the project's end result. A good project sponsor is a prerequisite for a great project manager. The sponsor is usually head of a program area and not normally a day-to-day user. The project sponsor is typically part of the organization's management and should be a strong advocate for the project.

Project Sponsor Responsibilities

General Functions

Articulate program or executive requirements.

Ensure that requirements are met.

Concept Definition

Define sponsor needs.

Ensure user support of project.

Planning

Review and approve project plan.

Participate in planning activities.

Approve funding along with Steering Committee.

Assign personnel through the Project Manger.

Attend Kick-off meeting.

Project Execution

Attend requirements reviews.

Provide written agreement to requirements.

Attend Steering Committee meetings.

Help resolve project problems.

Close-out

Attend lessons learned meeting.

Steering Committee Role

The management or the Steering Committee identifies the need of project, assesses project risk, and approves project commitments.

They are responsible for ensuring that project is consistent with organization strategic plan.

They are also responsible for developing the procedures to ensure that policies are followed.

The Steering Committee assists the project manager in planning the development effort and makes commitments to complete the project within established schedule and budget constraints.

Steering Committee Responsibilities

General Functions

Prioritize project needs.

Ensure that sufficient resources are available to conduct the project.

Review/approve commitments to external entities (e.g., vendors).

Concept Definition

Assist in staffing effort.

Review/approve Project Statement

Planning

Review/approve project plan

Review/validate and approve risk analysis.

Budget and establish financial reserves based on Risk Analysis Worksheet.

Project Start-Up

Ensure project staff availability.

Ensure that funding is available.

Project Execution

Regularly participate in executive management reviews and/or Steering Committee Meetings.

Approve changes to the project plan.

Review risk mitigation plans and act on Project Manager recommendations.

Review/approve changes in contract commitments.

Review/approve project deliverables.

Close-out

Participate in lessons learned sessions.

Accept and approve deliverables.

Approve project/phase completion.

Project Manager Role

The project manager has primary responsibility for the quality of a project's deliverables and its successful completion.

To succeed the project manager must work closely with the project sponsor to ensure that adequate resources are applied.

The project manager also has responsibility for planning and ensuring that the project is successfully completed on time and within budget. The project manager is assigned early in the conceptual and planning processes so the plan can be owned by the person responsible for its execution.

Project Manager Responsibilities

General Functions

Implement project policies and procedures.

Acquire resources through the Project Sponsor and Steering Committee.

Maintain staff proficiency and productivity, and provide training where required.

Establish and maintain quality in the project.

Identify and procure tools to be used on the project.

Concept Definition

Develop Project Statement including success criteria and constraints.

Conduct general cost/benefit analysis, if required.

Planning

Develop detailed project plan, tailoring methodology to reflect project needs.

Ensure that management, users, affected state organizations, and contractors commit to project.

Project Start-Up

Finalize project baseline plan.

Assign resources to project and assign work packages.

Finalize project quality and Configuration Management plans.

Project Execution

Regularly review project status, comparing budgeted to actual values.

Ensure that project plan is updated and approved as needed.

Review the results of QA reviews.

Participate in change control board to approve changes.

Update project risks and establish prevention and mitigation procedures, as required.

Close-out

Develop an action plan for any product that does not receive user sign-off.

Obtain user and management approval of final deliverables.

Close-out open action items.

Conduct lessons learned session.

Celebrate success.

Development Team Role

The Development Team has responsibility for conducting project activities defined by the project life cycle.

The development team includes the specialists responsible for implementing the project solution. Stakeholders should interact with the development team to ensure that requirements are correctly implemented.

Development Team Responsibilities

General Functions

Identify solution alternatives.

Implement solution within budgeted cost and schedule.

Coordinate with QA.

Support project planning and tracking activities.

Concept Definition

Provide general estimates for developing deliverables.

Conduct feasibility studies, if applicable.

Planning

Develop technical approach and associated estimates and schedules.

Assist in the development of a QA/CM plan.

Identify productivity tools for project.

Project Start-Up

Ensure that all members of the development team understand the project plan and requirements.

Coordinate staff training efforts.

Establish the project's development facilities and environments.

Project Execution

Submit status reports to the Project Manager.

Conduct work using accepted Development Lifecycle Methodology.

Coordinate with QA, review QA results, and correct any deviations.

Help establish baseline documents.

Develop project deliverables.

Establish testing plan and coordinate test activities.

Identify risks as they are found.

Participate in change reviews including performing Cost Schedule Impact Analysis.

Close-out

Participate in lessons learned sessions.

End User

End users are responsible for ensuring that their needs are expressed and for verifying that a completed project meets those expressed needs.

End User Responsibilities

General Functions

Articulate user requirements.

Ensure that requirements are met.

Ensure that staff are "ready to accept" the new system.

Be proponents of new system.

Concept Definition

Define user needs.

Planning

Review project plan (as part of Steering Committee).

Project Start-Up

Assign user personnel to the project as required.

Project Execution

Assist in developing requirements.

Review design.

Provide written agreement on requirements and qualifying criteria.

Assist in user testing.

Approve delivery and implementation procedures.

Review current business practices and the impact the new process or system will have on the practices.

Develop procedures, policies, and processes to support the new system.

Close-out

Sign-off on deliverables.

Attend lessons learned meeting.

Change Request Form (Cerere de Modificare)

Cerere de Modificare

Modificarea Propusa: _____ _______ ______ _____________ Data: _____________

Initiator: __________ ______ ____ _ Organizatia: _______

Descrierea Modificarii Propuse si Referinte (documente, meeting, manager, etc):

Justificare:

Impactul in cazul in care modificarea propusa NU se implementeaza:

Alternative la aceasta propunere de modificare:

Proiect:  _________________ Data: ________

Numar de Control: _________________

(Aceasta sectiune se completeaza de Managerul de Proiect Softwin)

Analiza Impactului Initial

Plan de Proiect (Baseline) Afectat: __________ ______ ____ ______

Componente (Module) ale Proiectului (Sistemului) care sint afectate:

__________ ______ ____ __________ ______ ____ __

__________ ______ ____ __________ ______ ____ __

__________ ______ ____ __________ ______ ____ __

__________ ______ ____ __________ ______ ____ __

Este necesara Analiza Impactului asupra Costului / Planningului ?  Nu___  Da___

Analiza pregatita de: __________ ______ ____ _________________

Impact Cost: __________ ______ ____ _____ _______ ______ ________

Impact Planning (Schedule): __________ ______ ____ ___________

Impact Resurse: __________ ______ ____ _____ _______ ______ ______

Rezultatele Reviziei Finale: __________ ______ ____ ____________

Data Reviziei:___________

Clasificare Impact:   ____MARE ____MEDIU ____SCAZUT

Rezultate Revizie:

Data Revizie:_____________ Atribuit lui: _______________ Organizatia:_________________

Decizia asupra implementarii modificarii cerute:

___Aprobare Implementare ___Rejectare ___Aminare (data): ___________

Motiv:

Semnatura Persoanei Responsabile:

Risk Management Worksheet

A description of all risks identified for the project, the probability of the risk occurring, the impact of the risk on the project, and the suggested mitigation activities.

Last Risk Assessment Date: Prepared by:

Ref

#

Risk Category/ Event

Loss

Hours

Probability

Risk Hours

Previous Risk Hours

Preventive Measures

Responsible

Person

Comments

Personnel

Equipment

Customer

Customer

Logistics

Organization

Other

TOTAL RISK HOURS

Risk Reserve:

Suggested Preventive and Contingency Measures

Provide appropriate training.

Hire trained specialists.

Purchase additional equipment.

Implement product functionality in a phased manner.

Get agreement on who has decision authority; designate key user responsibility.

Negotiate better environment.

Ensure that all the resources are provided.

Adjust deadline and get our customer buy-in.

Do not commit to third-party performance.

Get third party commitment at least equal to (if not more than) our commitment.

Get customer commitment to participate in the project.

Increase estimates for the related tasks.

Do not commit to response time unless absolutely necessary and, then only if a study is done by knowledgeable persons.

Establish access to product support personnel.

Hold regular meetings with customer.

Maintain constant written and oral communication with remote personnel.

Demonstrate incremental results.

Divide staff into teams and assign team leaders.

Dedicate our management resources.

Establish final authority of our project manager.

Use proven hardware for development if possible.

Reduce functionality to meet deadline.

Document our assumptions and understandings and get Customer's sign-off before investing substantial resources.

Design an alternate (contingent) solution strategy.

Politica de confidentialitate | Termeni si conditii de utilizare

DISTRIBUIE DOCUMENTUL

Comentarii

Vizualizari: 2464
Importanta: rank

Comenteaza documentul:

Te rugam sa te autentifici sau sa iti faci cont pentru a putea comenta

Creaza cont nou

Termeni si conditii de utilizare | Contact
© SCRIGROUP 2024 . All rights reserved
